Jonathon Levi Architects fleshes out new school building design.

EverythingWestport.com

Sunday, July 9, 2017

Photos | EverythingWestport.com



By Robert Barboza

Special Correspondent to EverythingWestport.com



WESTPORT – The Westport School Building Committee continues to refine floor plans for a new co-located junior and senior high school on the site of the closed Westport Middle School, getting the latest updates on recent changes in the design on June 28 from owner’s project manager Dan Tavares and architect Jonathan Levi.



It will be a challenge for School Building Committee members to manage JLA “esthetics versus functionality” paradigm as they flesh out final plans for the co-located school building on Old County Road.



Tavares said that both a finalized site plan and completed floor plans should be completed by August 4th, when the design team begins preparing firm cost estimates for the project.



The building committee is scheduled to present finalized plans and cost estimates to the Board of Selectmen and Westport School Committee at a joint meeting set for September 6, according to Building Committee Co-chair Dianne Baron.



If the plans and budget are approved by those two boards, the project package would be submitted to the Massachusetts School Building Authority (MSBA) by September 14th to get on the agenda at the October MSBA meeting, Baron said. A quick MSBA approval would firm up the town’s reimbursement numbers from by the state agency, and help determine what local funding is needed for the project.



Baron noted that the building committee will have time to make a few last-minute, cost-cutting adjustments to “finalized” specifications if cost estimates are too high. Levi offered some “alternate” or optional parts of the project that could easily be cut out or scaled back to cut costs if the overall budget is too large; those options would be included in draft bid specs, he indicated.



Early preliminary (building) designs are experiencing major changes as the building committee prefers “front-door drop-off” over the proposed rear of the building; and JLA in mid-steam has proposed “flipping” the high school portion of the building with the middle school portion to accommodate operating functionality.



While the majority of the site plan work is done, the building committee asked for more work on the proposed traffic pattern, including a planned school bus drop-off point at the rear of the building. Several members expressed a preference for drop-offs at the front of the building, allowing middle schoolers and high school students to be immediately routed to their separate academic wings.



EW 06/28/2017





Building committee member Tony Vieira expressed concerns about the encroachment of athletic fields serving the new school invading the adjoining Westport Elementary School (WES) campus. The new fields seem to cut back the outdoor space currently used for physical education classes, he noted.



“They should have the same amount of space at the elementary schools for physical education activities as they do now,” Vieira suggested, noting that some woods to the north of school could be used to make a new space for those classes. Incorporating that effort into the project plans will be considered at a future meeting.



EW 06/28/2017



Above: The newest version of the site plan showed two regulation-sized baseball and softball diamonds behind the new junior/senior high school, with both spaces used for field hockey and soccer in the fall. Two small practice fields are located in front of the school, near the road.



The newest version of the site plan showed two regulation-sized baseball and softball diamonds behind the new junior/senior high school, with both spaces used for field hockey and soccer in the fall. Two small practice fields are located in front of the school, near the road. One less softball field than originally planned is shown in the latest revisions.



The four tennis courts between the current school building and the nearby public library would be relocated to open space behind the library, and a fifth court added, Levi indicated.

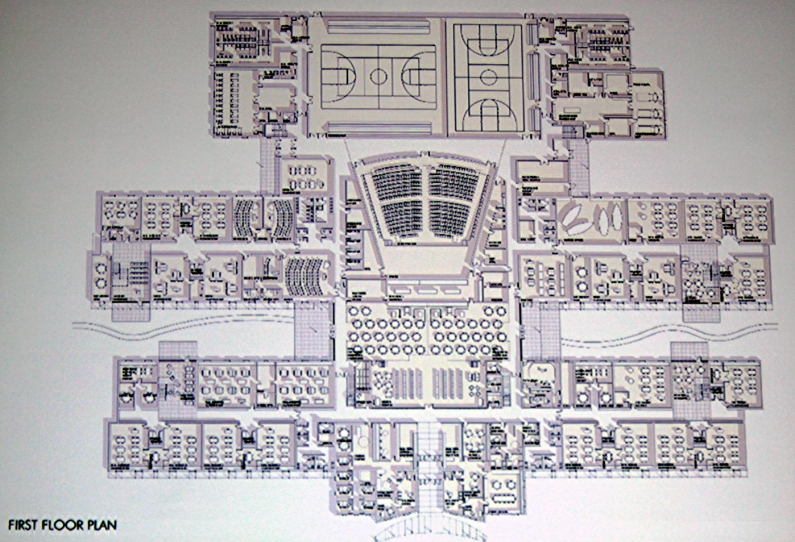

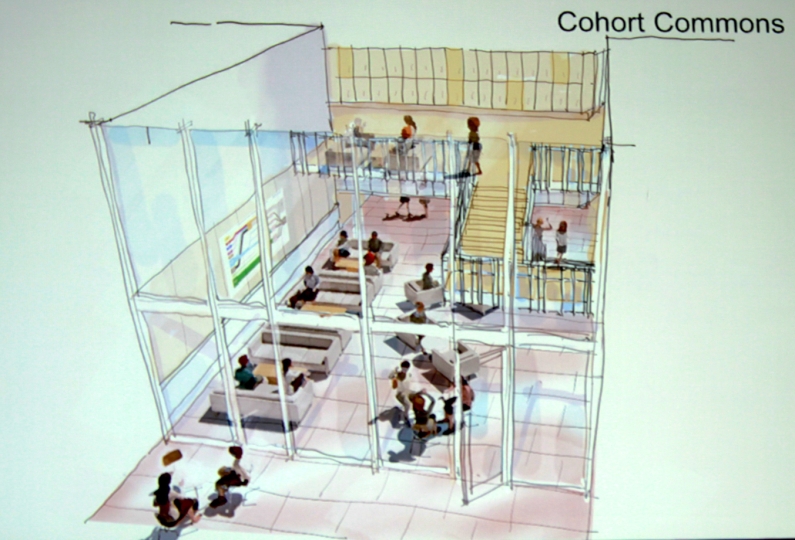

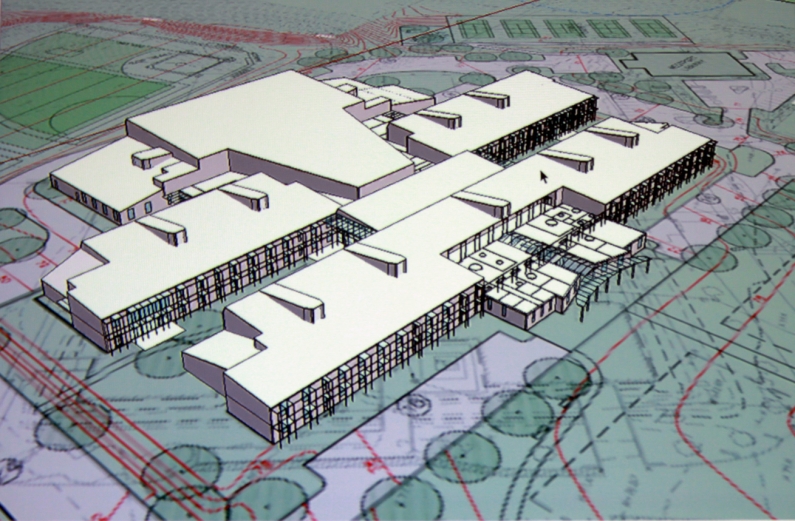

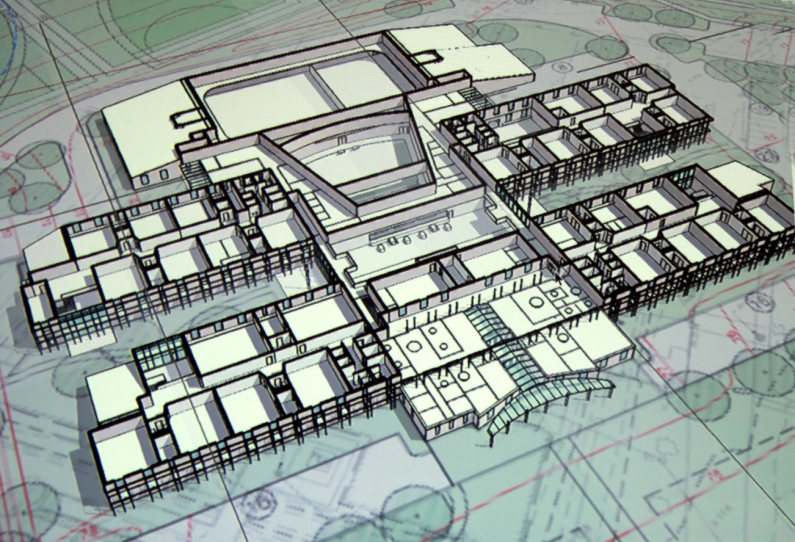

Superintendent Ann Marie Dargon and various school staffers have been working with the design subcommittee to finalize floor plans for the two-story H-shaped building in recent weeks. The floor plan calls for the high school wing on the west side of the building, and the middle school wing on the east side, with a shared front entrance and separate administration offices for the co-located facility.

Design refinements are allowing the overall square footage to be reduced in every new version of the concept plans, Levi said. The reduced footprint will help keep building costs down, he noted.

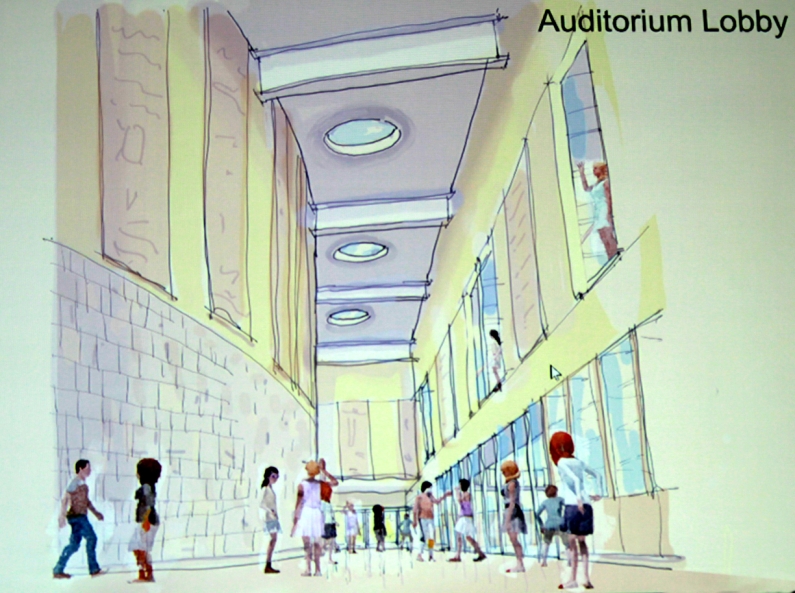

The two wings would share a centralized cafeteria, kitchen, and learning commons, plus have a large auditorium helping to connect the two wings. A generously-sized back lobby will offer after-hours access to the auditorium and adjoining gymnasium on the north side of the building.

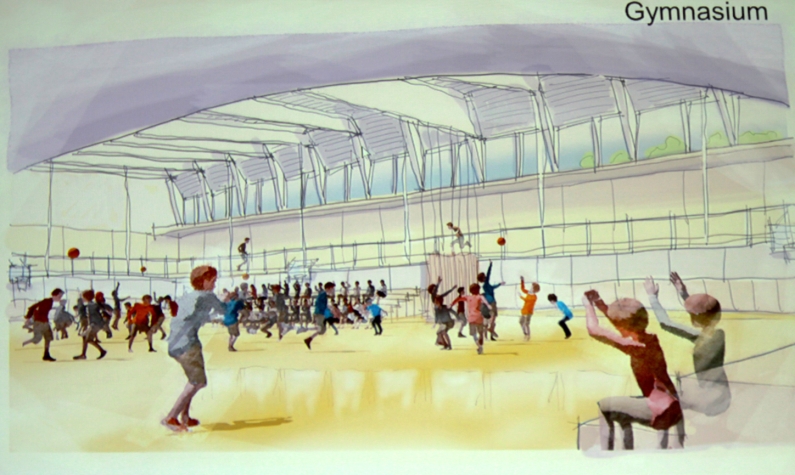

The dividable gym will feature two basketball courts for separate use by middle school and high school physical education classes during the day, and both the gym and auditorium will be accessible after hours via “public” side entrances when the rest of the school is closed off.



Tavares said planners will soon meet with police and fire department officials to get their input on proposed safety and security issues, needed to finalize the floor plans.



Another big decision coming up is the proposed exterior appearance. Levi surveyed all of the municipal buildings in town and found that except for Town Hall and several school buildings, “all of them are shakes and shingles” on the outside. Traditional brick, or a mix of stone and shingles is another option to consider, he suggested.



“I want to make a building that fits in with the town,” the Drift Road resident said. His preference would be “a lot of shingles, a lot of stone” for the new school, he indicated.

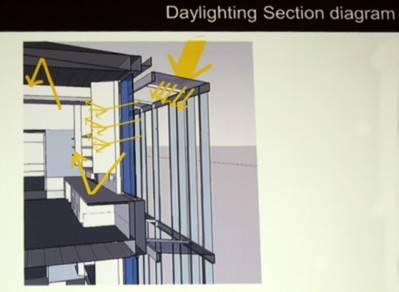

Despite the traditional exterior proposed, Levi is recommending lots of glass for passive solar energy and access to the outdoors.



He is also pitching the school roofs to maximum their solar power collection abilities, he said.

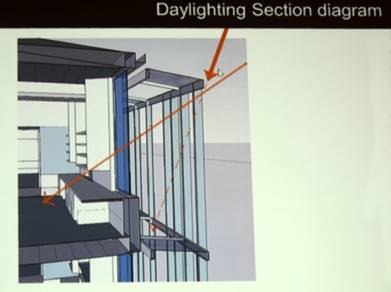

He is also proposing use of specially-designed windows that block the sun’s rays in summer time to help keep the building cool, but allow sunlight coming in from a different angle during the winter months to generate heat and light. One architect’s sketch proposed a framework of support poles for “sun shades” along the front of the building, shading the south side in summer but permitting winter sunshine to get through. (see below)







Still to be firmed up are the demolition costs, estimated at around $8 million before the Middle School was shut down several years ago. Tavares told the building committee he wants to “double-check” those old numbers for remediation and demolition costs.



The total project budget includes that $8 million for abatement of the hazardous materials in the closed school, and demolition and disposal costs; Tavares noted “some” soil remediation funding in the demolition budget, but wants to make sure the estimates are still accurate.



EW 06/28/2017



















EW 06/28/2017
